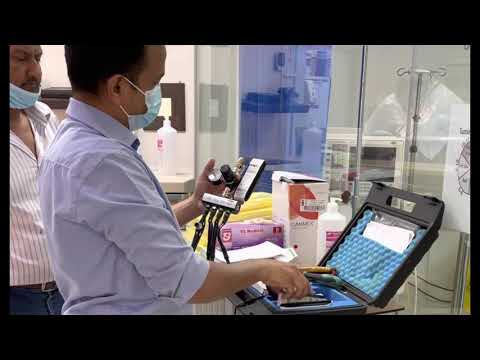

Medical gas outlet testing after installation is the commissioning step that separates a working OR from a liability. The outlets — the wall or pendant points where oxygen, air and vacuum connect — carry pressure and flow specifications that must be verified on site, under load, before clinical use. For hospital projects and distributor installations, the post-installation test protocol is part of the acceptance handover, and its documentation is part of the facility file. This guide covers what the tests are, the numbers, and who should run them.
What the Installation Tests Verify
Two properties define a medical gas outlet: pressure and flow. The pressure test verifies that each outlet delivers the system pressure at the point of use — oxygen and medical air at the standard operating pressure (commonly 4 bar / 400 kPa in most markets, with the specific value per the national standard), medical vacuum at the negative pressure spec. The flow test verifies that the outlet delivers the required flow under load — the test runs the outlet at its rated flow (the common general-purpose outlet rating is 100–200 L/min for oxygen and air, 40 L/min for vacuum, with the numbers varying by standard and application) while checking that the pressure holds within tolerance. The third check is the alarm and shut-off verification: the zone valves and the alarm system respond correctly when an outlet or zone is isolated. The testing standard that governs the whole exercise is the facility-gas standard of the destination market — the NFPA 99 health care facilities code is the reference for North America, and equivalent national standards apply in other markets.
The Test Sequence After Installation
The post-installation sequence runs in four steps. Step one, purity and cleanliness: after the pipeline is flushed, the gas quality is verified (oxygen purity and the absence of contamination) before any outlet is put into service. Step two, outlet-by-outlet pressure and flow testing: each outlet is tested individually at rated flow with the pressure recorded — the pass criterion is the pressure holding within the tolerance band at the rated flow, and every outlet gets a test record. Step three, alarm and valve verification: the zone valve operation and the alarm set-points are verified with the documented response. Step four, the labeling and documentation handover: the outlets carry their final labels (gas type, outlet type) and the test certificates are bound into the facility file. The discipline that matters: the tests run on the installed system, not on the components — a bench-tested outlet is not a tested installation, because the pipeline, the joints and the outlet’s seating are what the on-site test actually verifies. The medical gas pipeline design guide covers the design-side specs, and the gas outlet standards guide covers the outlet-level requirements.


Who Runs the Tests and What the Records Show
The testing responsibility splits three ways. The installer runs the initial commissioning tests with calibrated equipment. The independent verifier (a third-party gas testing firm or the hospital’s engineering consultant) re-verifies a sample or the full set for the acceptance record — the independence matters because the acceptance record is the liability document. The equipment supplier (pendant or outlet manufacturer) provides the component certificates that the installation testing builds on. The record for each outlet should show: the outlet identifier, the gas type, the tested pressure at rated flow, the test date, the tester’s identity, and the calibration certificate of the test equipment. A handover without these records is a handover without acceptance — and the records are also the baseline for the periodic re-testing that facilities run on a schedule. Sanyang’s installation support packages the outlet and pendant certificates with the equipment, and the installation and maintenance hub covers the handover documentation structure.
The Procurement Angle: What Buyers Should Contract
The buyer’s contract should name the testing scope before the PO: who runs the pressure and flow tests, who verifies independently, what the acceptance criteria are (the standard’s tolerance bands), and what records are delivered. The equipment spec matters here — outlets and pendants with clear test documentation (factory pressure-test certificates, the outlet’s rated flow published) make the installation testing straightforward; equipment without the factory documentation pushes the testing burden and the risk onto the project. For distributor programs, the same discipline applies at the sample stage: the sample pendant or outlet should arrive with its factory test data, so the distributor can pre-verify the numbers before the container ships. The medical pendant range lists the outlet configurations and ratings, and the turnkey OR page shows how the gas testing is scoped into the full project package.
FAQ
What is tested on a medical gas outlet after installation?
Pressure at the point of use (oxygen and air at the standard operating pressure, commonly 4 bar), flow under load (100-200 L/min for oxygen/air, 40 L/min for vacuum per common ratings), plus alarm and zone valve response.
Why test on the installed system rather than the components?
Because the pipeline, joints and outlet seating are what the on-site test verifies; a bench-tested outlet is not a tested installation.
What records should the handover include?
Per-outlet records showing identifier, gas type, tested pressure at rated flow, test date, tester identity, and the test equipment’s calibration certificate.
What standard governs medical gas testing?
NFPA 99 (health care facilities code) for North America, with equivalent national standards in other markets; the contract should name the standard and its tolerance bands.
Contract the test scope, run the sequence on the installed system, and hand over the records: the acceptance file then protects everyone. Related reading: pipeline design and the pendant range.
For module pricing and the post-repair check list, see our LED module replacement cost guide.
Defects are cheapest before the crate closes and before the room opens; our FAT and SAT acceptance testing guide covers both test stages.
Vacuum Terminal Flow: The ISO 7396-1 Benchmark
Vacuum pipelines are tested under the same framework as compressed gas lines: ISO 7396-1 governs medical gas pipeline systems for both compressed gases and vacuum. For surgical vacuum terminals, the commonly specified design point is a free-air flow of around 40 L/min per terminal, so a flow check at commissioning should confirm each outlet delivers that rate at the working vacuum level before sign-off. In practice, test each terminal with a calibrated flowmeter and gauge, then verify that simultaneous demand from multiple terminals does not collapse the reservoir pressure below the alarm threshold. Where a terminal reads low, check the branch valve position and the line for restrictions before blaming the central vacuum plant.
